NOTICE: Upcoming Traffic Management

0

Please see Weekly Lookahead for 21st October- 25th October 2019

 FHR

Carriageway construction (Milling/ Baseworks and paving) continues in Phase 1D between Cedar Valley Junction and W.I.O Pond.

Local access will be maintained; however residents within closure are asked to enter/ exit closure from the south.



APUA Telecoms plan to carry out works on FHR phase 2 at Electric Avenue

Date: 7am on Saturday 19th – 6pm Sunday 20th October.

Duration: 2 days

Traffic Management: Single Lane Traffic



SGWH

Roundabout construction at VC Bird International Airport to commence this week. Phase 1 (west side) of roundabout to be constructed first.

Date: Monday 21st  October 2019

Duration: 4 days

Traffic Management: Single lane traffic with use of 3-way traffic lights

Construction of phase 2 (Northern side) of roundabout as follows:

Date: 25th October 2019

Duration: 3 Days

Traffic Management: Single lane traffic with use of 3-way traffic lights

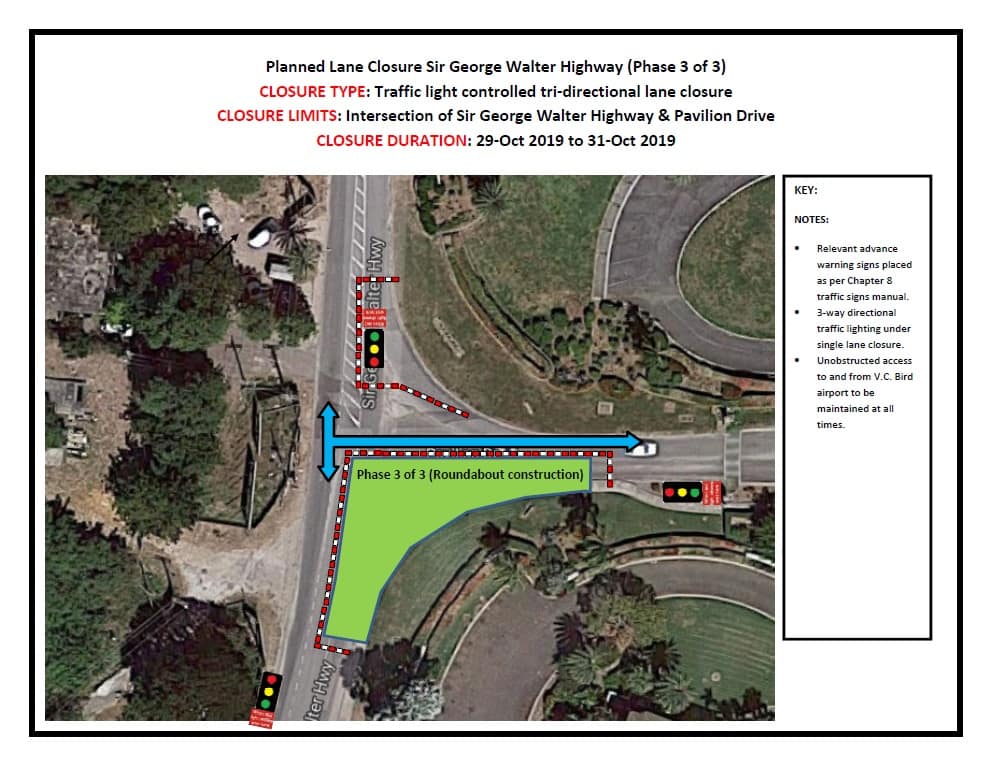

Construction of Phase 3 ( Southern  side) of roundabout as follows:

Date: 29th October 2019

Duration: 3 days

Traffic Management: Single lane traffic with use of 3-way traffic lights



Drainage works to commence in the following areas:

 Monday 21st October 2019

  • Crossroad culvert to be installed south of solar farm ( Sta 74+00)

Duration: 3 Days

Diversion: Track to be created for north and southbound traffic



Wednesday 23rd October 2019

  • Side road culvert to be installed at Coolidge Junction

Duration: 3 Days

Diversion: Track to be created for north and southbound traffic
